What Changes Are Made To The Risk Register As A Result Of A Qualitative Risk Analysis
Qualitative Run a risk Analysis is a simple and toll-effective fashion to manage project risks.
What is Risk Analysis?
Once you lot have identified the risks that could affect your project, you need to make up one's mind which ones yous will spend time and money on.
Chance analysis is the process of prioritizing risks based on the probability of the risk occurring and the touch on it would have on the project.
There are 2 primary methods of take a chance analysis you tin use on your project...
- Qualitative Risk Analysis
- Quantitative Chance Analysis
The chief difference between these two methods of risk analysis is that qualitative risk analysis uses a relative or descriptive scale to measure the probability of occurrence whereas quantitative take a chance assay uses a numerical scale.
Module 11 of the PM PrepCast is all about Project Risk Management.
Consider this written report plan if you're preparing to have your CAPM or PMP Certification exam.
Disclosure: I may receive a committee if you buy the PM PrepCast with this link.
For case, a qualitative assay would use a scale of "Depression, Medium, High" to indicate the likelihood of a risk event occurring.
A quantitative assay will determine the probability of each risk event occurring. For example, Risk #ane has an 80% chance of occurring, Risk #2 has a 27% chance of occurring, and and so on.
The residual of this article will focus on using qualitative analysis to prioritize and decide which risks your project should focus on.
The Risk Assessment Matrix
A Adventure Assessment Matrix (RAM) is a tool to assistance you determine which risks you demand to develop a risk response for.
The commencement step in developing a RAM is to define the rating scales for likelihood and impact.
In a qualitative analysis, likelihood or probability is measured using a relative scale. Here's an example Likelihood Calibration definition...
Rating | Likelihood | Description |
one | Very Depression | Highly unlikely to occur. May occur in exceptional situations. |
ii | Depression | Virtually likely will not occur. Infrequent occurrence in past projects. |
3 | Moderate | Possible to occur. |
4 | Loftier | Likely to occur. Has occurred in past projects. |
five | Very High | Highly probable to occur. Has occurred in past projects and conditions be for it to occur on this project. |
Here's an example Touch Scale definition...
Rating | Impact | Price | Schedule |
1 | Very Low | No increase in upkeep | No change to schedule |
two | Low | < 5% increase in budget | < ane week delay to schedule |
iii | Moderate | 5-x% increment in budget | 1 - two weeks delay to schedule |
four | High | 10-20% increase in budget | 2 - iv weeks delay to schedule |
5 | Very High | > 20% increase in budget | > iv weeks delay to schedule |
Remember, these scales are very dependent on the specific details of your projection.
For example, a "Low" likelihood of occurrence for i project may mean a risk effect is unlikely to occur within the next 10 deployments. With some other type of project "Depression" may mean that a risk result is unlikely to occur within the next year.
The bear upon calibration for your projection could besides include other considerations such equally scope, political, and employee impacts.
With your rating scales prepared, you tin create a Gamble Assessment Matrix to help you categorize the Gamble Level for each risk consequence.

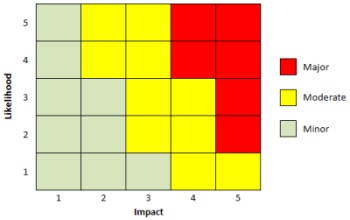

Risk Cess Matrix
For instance, if a take a chance event has a Moderate Likelihood of occurring and a Loftier touch on, information technology would exist considered a Moderate Risk using the RAM shown above.
Qualitative Risk Assessment
Pass your PMP Exam!
The PM Examination Simulator is an online test simulator.
Realistic exam sample questions so yous tin can pass your CAPM or PMP Certification exam.
Disclosure: I may receive a commission if you purchase the PM Exam Simulator with this link.
Using your RAM and Rating Scales, y'all tin so analyze the likelihood of each take a chance issue occurring and its impact to determine what Hazard Level it is at. This will give y'all the information you need to prioritize your list of project risks.
A qualitative risk cess can as well aid y'all make up one's mind if there are any specific types or categories of risks that would crave special attending or any risk events that demand to be handled in the near-term.
The most challenging aspect of performing a qualitative risk analysis is defining your rating scales. But once that has been washed, you can use them for the duration of the projection to finer manage your projection'south risks in a timely fashion.
Exercise You lot Want More than Projection Direction Tips?
Subscribe to Projection Success Tips , my Gratuitous Project Management Newsletter where I share tips and techniques that you tin can apply to get your Project Management Career off to a great start.
As a BONUS for signing up, y'all'll receive admission to my Subscribers Merely Download Folio! This is where you can download my " Become A Project Manager Checklist " and other project direction templates.
Don't wait...
Source: https://www.project-management-skills.com/qualitative-risk-analysis.html
